Sauce & Spoon Tablet Rollout Project
The Sauce & Spoon Tablet Rollout Project served as my capstone project during the Google Project Management Course. In this project, I assumed the role of Peta, the Project Manager responsible for preparing all necessary project documentation from inception to completion, ensuring a successful project launch.
Sauce & Spoon, a small restaurant chain, is embarking on the Tablet Rollout Project to align with its annual growth and expansion objectives. In a strategic move, the decision was taken to initiate a pilot project, testing the implementation of new tabletop menu tablets at two selected locations before a full-scale rollout across the entire chain. The introduction of these tablets aims to enhance operational efficiency by enabling the restaurant to serve more guests in less time, minimize waste, and elevate overall customer satisfaction. This project represents a pivotal step toward optimizing restaurant operations and supporting the company's broader goals for expansion.
In my journey through the Google Project Management Course, I actively engaged in a range of tasks and challenges that showcased my proficiency in project management. From analyzing project documents to mastering effective communication techniques, here is a list of achievements demonstrating my capabilities:
List of Achievements:
Analyzed project documents and supporting materials to identify project requirements, evaluate stakeholders, and solve problems.
Completed a project charter and utilized it as a tool to align project scope and goals among stakeholders.
Added specificity to project goals, making them SMART, and applied negotiation skills to prioritize project goals.
Built a comprehensive project plan by examining project documentation, conducting online research, and analyzing critical conversations to identify tasks and milestones.
Demonstrated effective communication techniques for making accurate time estimates for project tasks.
Defined and described quality management standards, evaluating against those standards to ensure the project achieved the required quality.
Generated evaluation questions from survey questions and recognized how to share qualitative data effectively.
Learned strategies to facilitate a productive retrospective by encouraging participation, accountability, and positivity.
Acquired skills on how to communicate and escalate project problems to stakeholders, demonstrating impact through effective reporting strategies.
Applied techniques for quality retrospectives and project escalation.

Project Charter

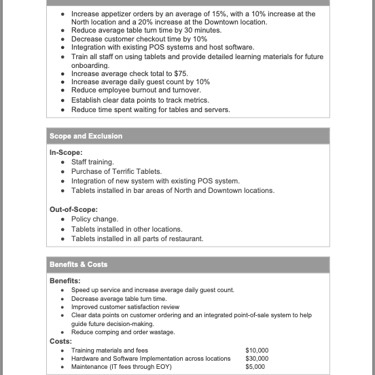

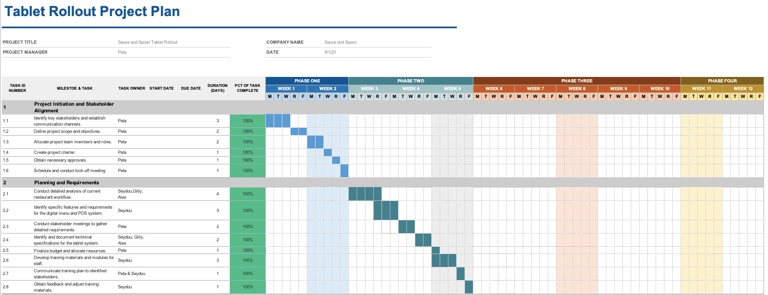

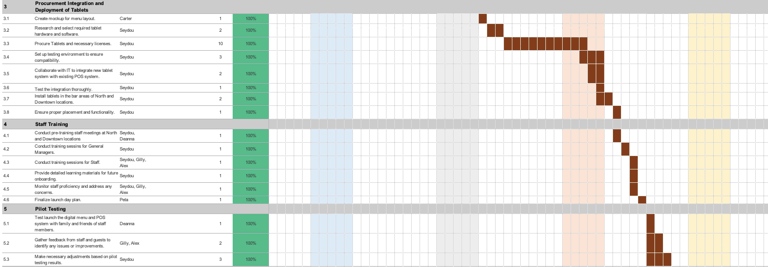

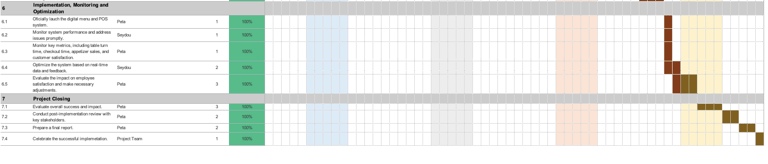

Project Plan- Dashboard

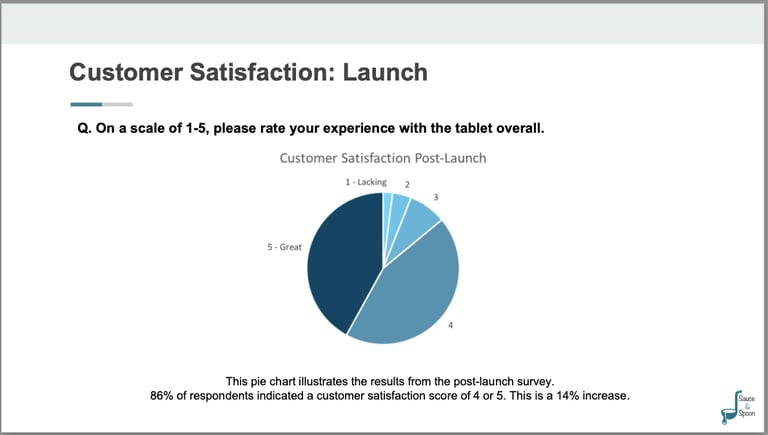

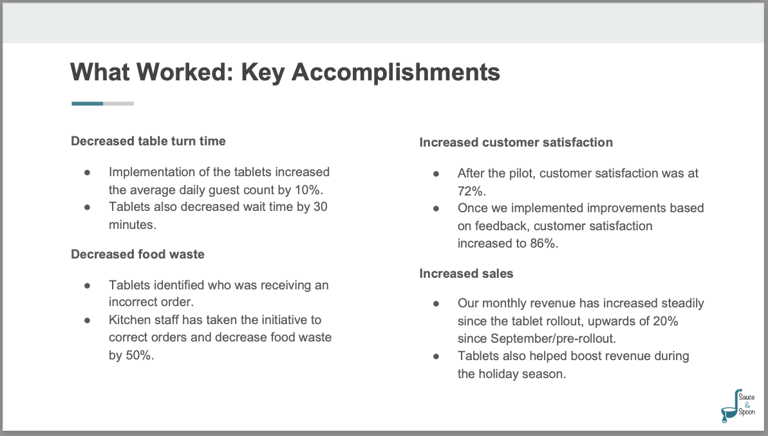

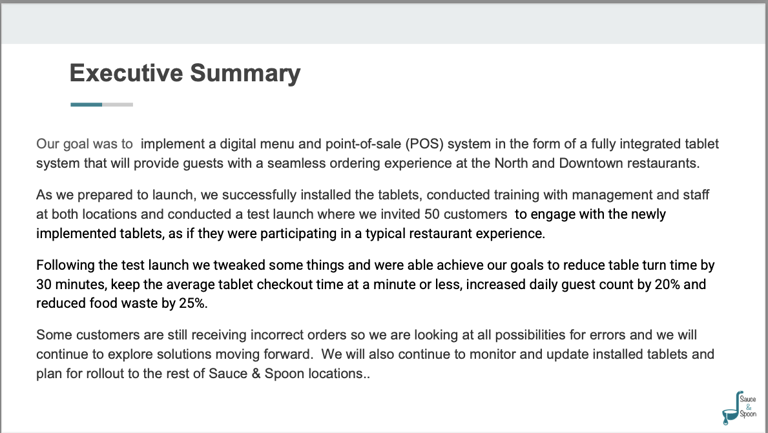

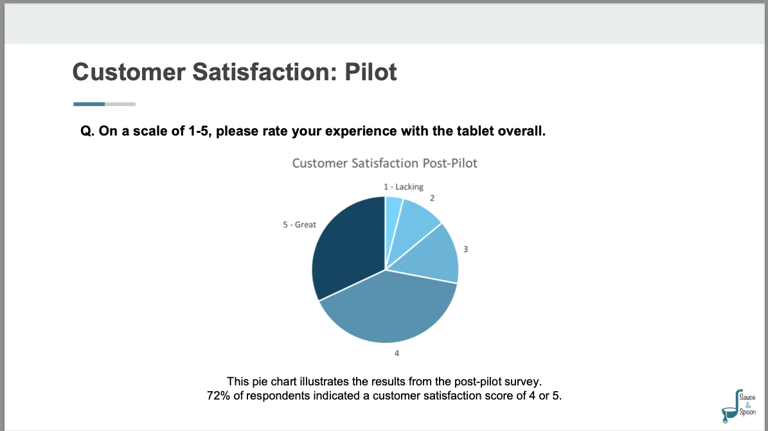

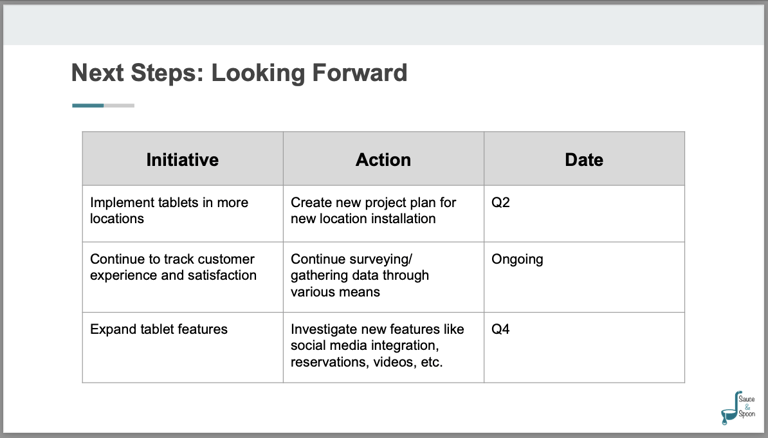

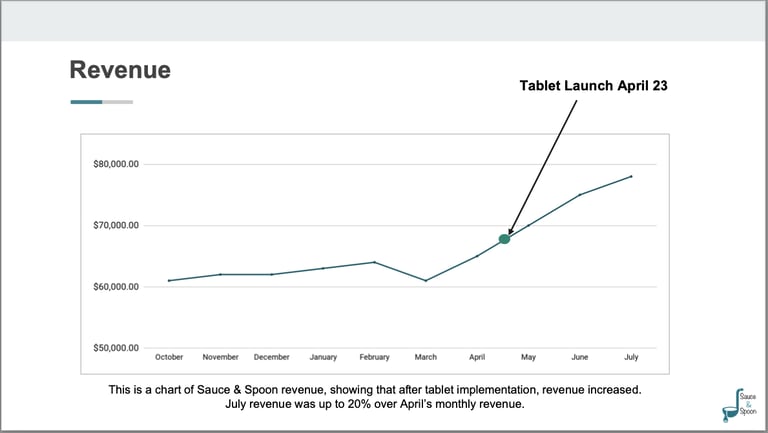

Test Launch Findings

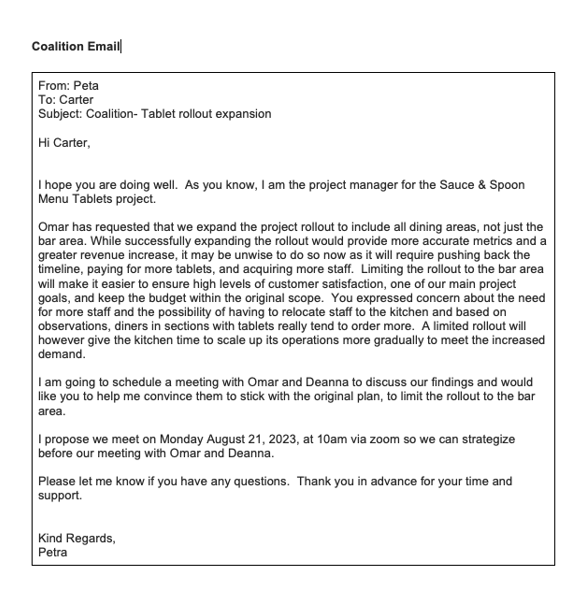

Coalition Email

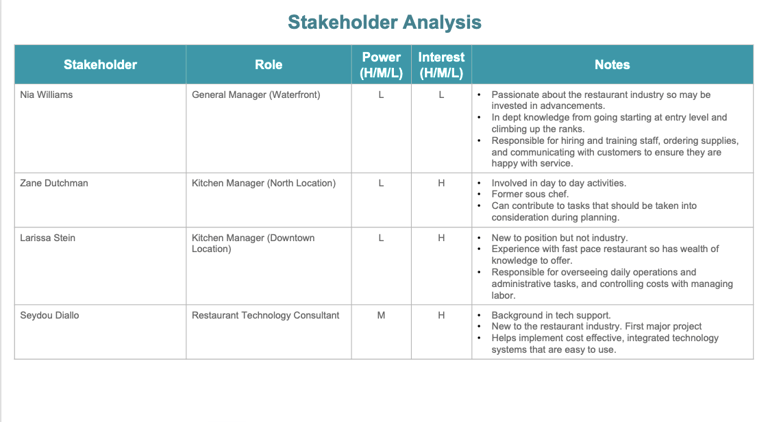

Stakeholder Analysis
